A practical buyer guide to confirming belt-roll weight, dimensions, split lengths, packing, unloading, access, storage and installation responsibilities before order release.
![]()

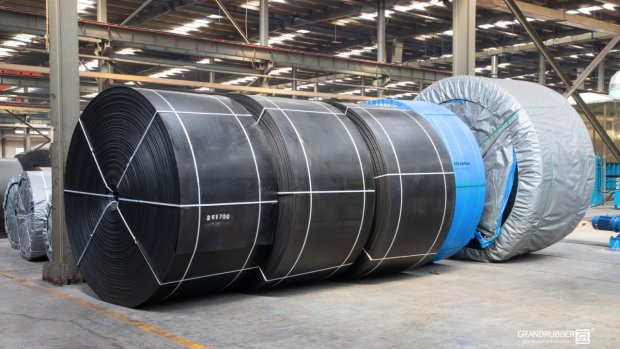

Conveyor belt rolls prepared in a workshop. The visible roll form supports order-planning discussion but does not prove belt grade, weight, dimensions, capacity or project history.
A conveyor belt order should not be released with only total length and width when the site has lifting, access, storage or installation limits. Before quotation, confirm the belt construction and covers, proposed length per roll, estimated net belt weight, gross packed weight, finished roll dimensions, core or reel details, lifting points, unloading equipment, route to the installation area, storage position and responsibility for each step. Ask the supplier to state the calculation basis and mark estimates for final confirmation.
Roll planning sits between product specification and site execution. Procurement may see one line for a belt of a stated width and total length, while logistics needs package dimensions and gross weight, maintenance needs a roll that can reach the conveyor, and the installer needs the correct running direction and sequence. If these groups work from different assumptions, a technically correct belt can still arrive in a form that is difficult or unsafe to unload and install.
The practical objective is not the largest possible roll or the lowest freight cost. It is a verified division of the ordered belt that can be manufactured, packed, transported, received, stored, moved and installed under one agreed plan.
Start with the released belt specification. Width, ordered length, carcass or reinforcement, top and bottom cover thickness, edge construction, splice plan and any special features affect the physical roll.
Do not calculate transport or lifting requirements from a generic belt density or from another order unless the responsible supplier confirms that the basis is suitable. A similar-looking belt can have a different mass and thickness. Mark every preliminary value as an estimate and define when it will be confirmed.
Ask the supplier to separate four values: net belt weight, core or reel weight, packing and support weight, and gross shipping weight. The receiving team normally needs gross packed weight for unloading and transport planning. The installer may also need net belt weight and core information for the roll stand and pull-in plan.
A quotation should state what is included in each value. A calculation that excludes the core, protective wrap, skid or steel frame must not be used as the final unloading load.
![]()

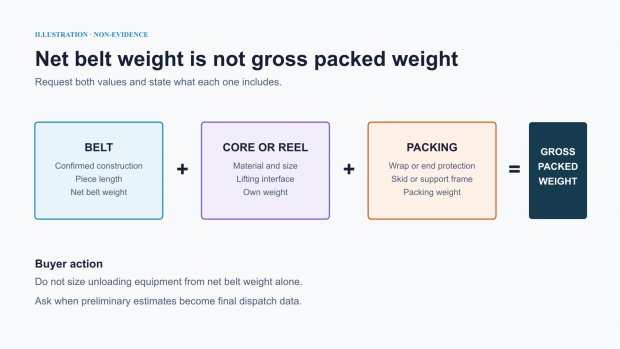

Illustration. Net belt weight excludes the core or reel and packing/support items unless the quotation states otherwise.
Request the expected outside diameter, face width or overall packed width, core inside diameter, core length, shaft or lifting arrangement, and any skid, frame, wrap, end plate or weather protection. Use consistent units.
A diameter without the core basis or a weight without the packing scope is incomplete. Ask whether the visible dimensions apply to the bare roll or the finished shipping package, and who will supply any shaft, spreader beam or special lifting accessory.
![]()

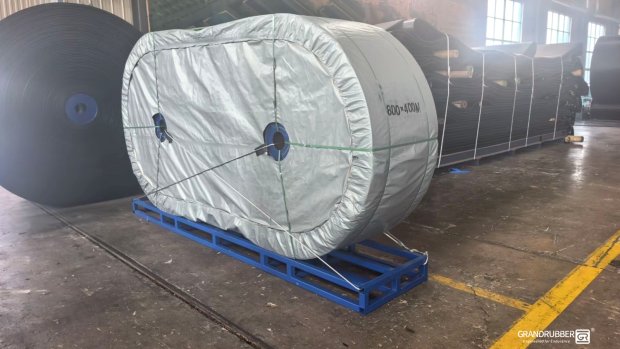

A wrapped roll on a support pallet. The photo shows visible packing context only; dimensions, weight, ownership and suitability remain subject to confirmation.
Evaluate the complete route, not only the first crane. Confirm the delivery vehicle, unloading point, ground and floor conditions, available crane or forklift, rated capacity at the required reach, fork length and spacing, lifting accessories, turning radius, doorway and aisle clearances, overhead restrictions, gradients, storage area, roll restraints and route to the conveyor.
The site should identify the most restrictive point and the competent party responsible for approving the method. A supplier estimate supports planning, but it does not replace the site-approved lifting and handling plan.
![]()

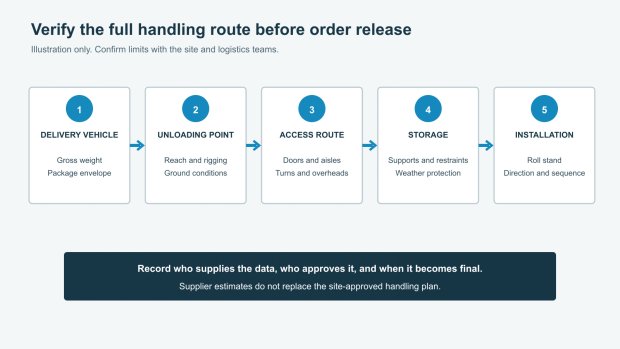

Illustration. Check the full route from delivery vehicle to installation position.
Ask the supplier to propose a roll schedule, then compare each option by gross weight, outside diameter, overall width, transport method, site access, number of field joints, installation time, labeling and responsibility.
Fewer, longer rolls may reduce field joints but increase package weight and access demands. More, shorter rolls may be easier to handle but can add joints, labeling and shutdown work. The selected plan should balance logistics and installation rather than optimize one stage in isolation.
![]()
Illustration. Longer and shorter rolls create different logistics and installation consequences.
Planning item | Buyer should request | Risk if unclear |
Net belt weight | Weight of belt material for each roll | May be mistaken for lifting or shipping weight |
Gross packed weight | Belt plus core/reel, protection and support | Unloading equipment may be undersized |
Finished roll envelope | Outside diameter and overall width | Roll may not pass the route or fit storage |
Core or reel | Inside diameter, length, weight and lifting interface | Shaft, forks or roll stand may not match |
Split-roll plan | Piece lengths, sequence and planned joints | Transport convenience may add installation work |
Responsibility | Who calculates, approves, unloads, stores and installs | Interfaces can be missed or assumed |
For a mine or quarry with limited lifting equipment, the maximum site-approved package weight may control the roll plan. The buyer should still review whether additional rolls create extra joints or longer downtime.
For a port or cement plant, access from the unloading area to the conveyor can be more restrictive than the truck or container. Door height, gallery width, floor loading, tight turns and the roll-stand location may determine the acceptable envelope.
For an EPC project, responsibility must be explicit. The belt supplier may calculate preliminary roll data, the freight provider may control vehicle limits, the site contractor may unload, and the installer may specify sequence and pull direction.
For a distributor, a warehouse may be able to receive a roll that the end user cannot. Keep supplier packing data, labels, gross weights, dimensions and sequence with the product record, then reconfirm the final site's limits.
Provide the complete belt specification: product type, width, total ordered length, strength or rating, carcass construction, top and bottom covers, edge, joint or splice requirement, quantity and application. Mark unconfirmed values instead of filling them from an old order.
For each proposed roll, request piece length, sequence number, estimated net belt weight, core or reel description and weight, packing or support description, gross shipping weight, outside diameter, overall width, core inside diameter, lifting arrangement, running-direction mark, belt identification and protection.
Add site limits: delivery mode, unloading point, maximum approved package weight and envelope, lifting equipment, rated capacity at the required reach, fork or shaft constraints, door and aisle clearances, turning space, storage conditions, roll-stand data, pull-in direction and installation sequence.
Clarify who proposes the roll plan, who approves it, who supplies lifting accessories, who unloads, who stores and protects the roll, who positions it for installation and who controls field joints. Request the roll schedule, packing list, label plan, handling notes and final weight and dimension confirmation according to the order scope.
● Using net belt weight as the unloading weight.
● Setting only a maximum weight while ignoring diameter and width.
● Splitting rolls only to reduce freight or crane demand.
● Treating a generic weight formula as final evidence.
● Assuming a crane nameplate equals safe capacity for the actual lift.
● Leaving roll sequence and running direction until dispatch.
Compare suppliers on the same released belt specification and the same logistics assumptions. Check whether each quotation states the proposed number of rolls, piece lengths, net and gross weight basis, outside diameter, overall width, core or reel, packing, markings and items requiring buyer approval.
A lower price is not directly comparable if the roll division, packing scope or handling responsibility is different. A useful supplier response should also identify uncertainty and state when preliminary data will become final.
GRAND RUBBER can help buyers organize the belt specification, proposed roll lengths, preliminary weight and diameter data, core and packing requirements, roll identification, destination and requested documents before quotation. We can also flag missing logistics inputs so procurement, the freight provider, receiving site and installer compare the same scope.
Final weights, dimensions, packing and roll schedule must be confirmed against the released order specification. Site lifting and handling approval remains with the responsible competent parties.
Not reliably. The confirmed belt construction, covers, thickness, core or reel, packing and roll division are also needed. Early figures should be labeled as estimates.
Ask for both. Net belt weight helps installation planning, while gross packed weight is normally needed for unloading, transport and storage planning.
No. It may reduce field joints but can exceed transport, lifting, access, floor, storage or roll-stand limits.
Request outside diameter, overall width, core inside diameter and length, plus any skid, frame, wrap or end protection that changes the shipping envelope.
No. The responsible site team should review the actual configuration, reach, rigging, ground conditions, load control and applicable procedure.
Confirm roll number, piece length, belt identification, running direction, sequence, gross weight, dimensions and any agreed handling or storage marks.
Send the confirmed belt specification, total length, preferred or maximum roll limits, unloading equipment, access restrictions, storage plan, roll-stand information, installation sequence, destination and document requirements. GRAND RUBBER can help organize a proposed roll schedule and identify values that need final confirmation.
